Eastbound H-1 Improvements Between Ola Lane Overpass and Likelike Highway Off-ramp
Overview
This project, commissioned by the Hawaii Department of Transportation (HDOT), has a dual objective: enhancing safety and alleviating congestion along the eastbound H-1 corridor spanning from the Ola Lane overpass to the Likelike Highway off-ramp. It seeks to achieve this by eliminating the center-lane merge from H-201 east of Ola Lane into H-1, as well as expanding both lanes and shoulders along this specific stretch of the H-1 highway. Furthermore, improvements will be made to the Gulick Avenue overcrossing to facilitate improved traffic flow on the H-1.
Traffic Control Plan at Gulick Avenue
Current Work Location: Area 2, 2a, 3, 4, & 4a
Upcoming Work Location: Area 5, 5a, &6
(updated 6/7)
Project Limits
H-1 Eastbound
The impacted H-1 corridor encompasses the eastbound lanes stretching from the Ola Lane overpass in the west to the Likelike off-ramp in the east. Throughout the project’s duration, both shoulders will remain closed, and intermittent lane closures will occur during non-peak hours. Additionally, there will be two days when this segment of the H-1 will be entirely shut down.
Gulick Avenue
Major work is also scheduled to take place on Gulick Avenue, in front of Kalihi-Waena Elementary School. This will involve lane narrowing, shifting, and occasional lane closures during construction phases.
For current traffic control plans, see above in “Overview”. For the most up-to-date information on current closures, detour maps, and other announcements and helpful resources, please consult the Lane Closures section.
Improvements
H-1 Widening
Widening the roadway on this segment of the H-1 will facilitate the removal of the center lane merge from the H-201 into the H-1 and allow the broadening of all eastbound lanes, alleviating congestion and enhancing safety.

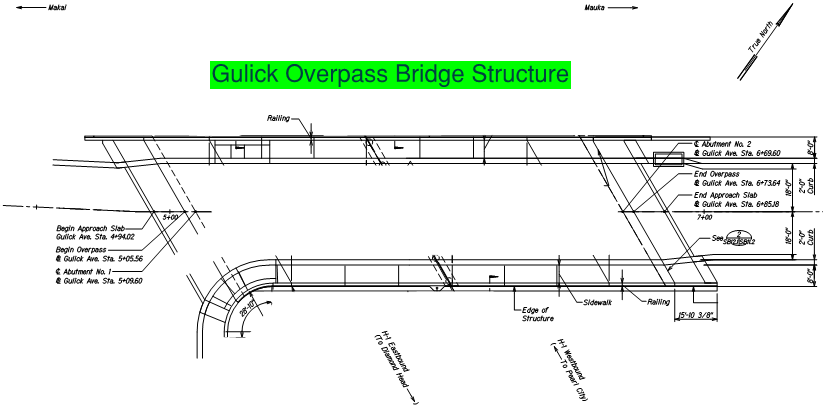

Gulick Avenue Overcrossing Enhancements
Improvements to the Gulick Avenue H-1 overcrossing will include extending the abutments on either side of the roadway by approximately 15.5 feet, in-filling a wall above the existing median, and increasing the bridge’s vertical clearance by 6 inches.
Schedule
The project is scheduled to begin on January 2, 2024 and continue until End of 2026.
- Working hours along the H-1 corridor will be 8:00 PM to 4:30 AM Sundays through Thursdays, and 8:00 PM to 7:00 AM Fridays and Saturdays. Crews will also be working during daytime hours in the closed shoulder section.
- Work along Gulick Avenue will occur Mondays through Fridays between 7:00 AM and 3:00 PM.
During construction operations, traffic lanes may be closed to the public in various locations within the project limits to allow the Contractor to perform their work. This may cause a slowdown in traffic within the construction area. Motorists are advised to drive with caution and observe all posted warning signs, barriers, and traffic control devices. Honolulu Police Officers will be posted according to approved traffic control plans to assist the Contractor in ensuring smooth traffic flow during construction operations.
- H1 corridor: Crews are currently relocating utilities, removing the existing slope and barrier wall, and installing the new barrier wall and lighting systm.
- Along Gulick Avenue, crews are relocating electrical utilities.
Current lane closures
H-1 Corridor
- There is a 24-hour closure of the Eastbound shoulder near Ola Lane overpass. Please proceed through this area with caution. Note, there may be slow-downs in the far right lane as the Contractor enters and exits the work area.
Gulick Avenue H-1 Overcrossing
- There is a single lane closure on Gulick Avenue, between 8am and 4pm, Monday through Friday. Please proceed with caution.
Project Milestones:
June, 2025: H1 Eastbound Water Main Relocation near Likelike off-ramp (projected 6 weekends of work with multiple lane closures on H1 EB day/night)
July, 2025: H1 Westbound Water Main Relocation near Likelike on-ramp (projected 6 weekends of work with multiple lane closures on H1 WB day/night)

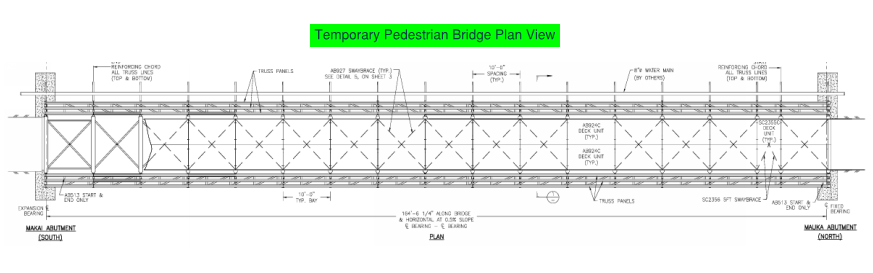

September, 2025: 2 nights full closure of freeway (1 night each direction) for the setting of the temporary pedestrian bridge installation near Gulick Avenue overpass.

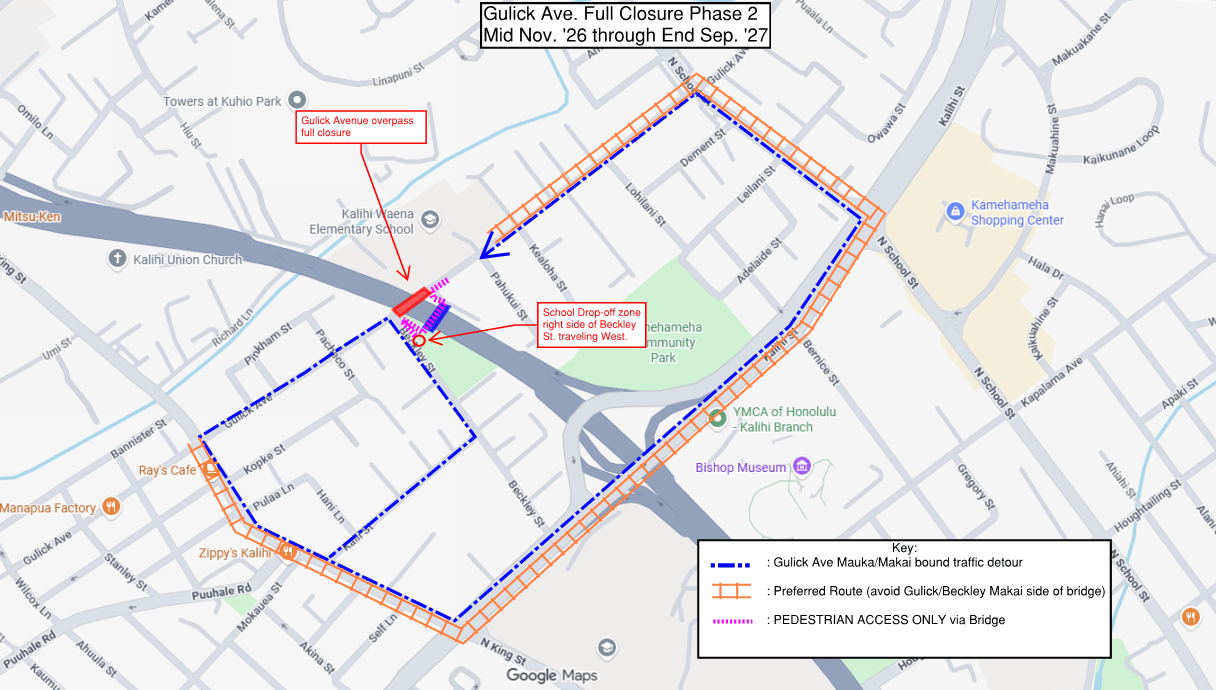

September through October, 2025: Full closure of Gulick Avenue overpass bridge for new bridge foundation installation.
March through September, 2026: Full closure of Gulick Avenue overpass bridge for bridge modification work.
End of 2026: Project Completion
Project Hotline: (808) 900-3314
Email inquiries: inquiries@h1widening.com
